Metro's Phase III project to bring green benefits to Delhi

The Phase III network comprises two new corridors--Mukundpur to Shiv Vihar and Janakpuri West to Botanical Garden--besides extension of several existing corridors of the network.

NEW DELHI: Greater connectivity is not the only benefit Delhi Metro's Phase III project will offer. According to a study commissioned by DMRC, the new corridors will help decongest some roads, reduce air pollution and save fuel costs as well.

Said a Delhi Metro spokesman, “There will be a significant dip in the emission levels. For instance, the reduction in carbon dioxide emission will be about 4.808 million tonnes by 2025.“

The Phase III network comprises two new corridors--Mukundpur to Shiv Vihar and Janakpuri West to Botanical Garden--besides extension of several existing corridors of the network.

Apart from helping cut the pollution levels, the Phase III of the Delhi Metro is expected to have an impact on the surface transport as well. The study , which was undertaken by RITES, says, “The requirement of buses is estimated to come down to 1,760 in 2025 if the Phase III is introduced according to the schedule. This will save an amount equal to Rs 4,682 million towards capital cost of the bus system.“

That's not all. The Phase III is expected to have an impact on savings in road infrastructure too. According to the RITES study , to accommodate the vehicles, the government will have to acquire 55 hec tares of land for parking and another 106 hectares (530km) to create additional road infrastructure. “The savings due to road infrastructure will be about Rs 10,600 million. In addition, the cost of 161 hectares of land will also be saved on implementation of the DMRC Phase III project,“ the study goes on to say.

The Phase III will also help towards savings on fuel consumption, which is expected to be in millions of rupees per year. These savings are, in fact, one of the primary aspects of the study , said officials.

Delhi Metro had in its previous phases also helped significantly in cutting fuel costs as well as reducing emissions. According to data by the Delhi Metro, in Phase I of its network (2007), the number of vehicles that went off roads daily was 16,895.This went up to 3,90,971 last year, by which time Phase I and II came about.
ADVERTISEMENT

Meanwhile, the annual reduction in pollutants was 31,520 tonnes in 2007 and 5,77,148 tonnes in 2014. The savings in time per trip was 31 minutes in 2007 and 28 minutes in 2011, when Phase I and II became functional. It was 32 minutes last year.
Delhi Metro reaches highest point at Dhaula Kuan
1/10

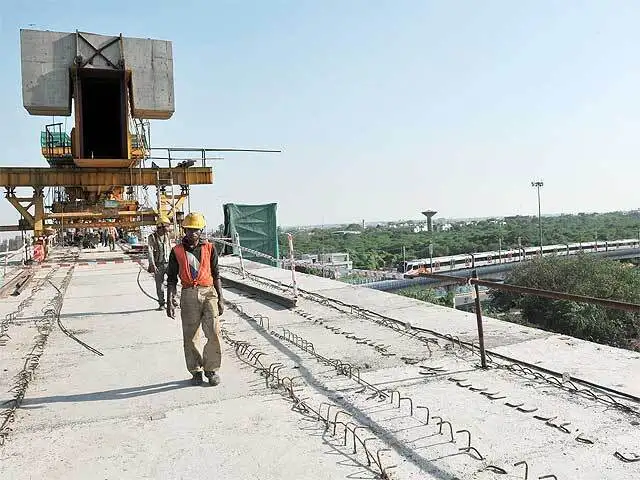

A Metro train passed through Delhi Metro's highest point at a height of 23.6 metres in Dhaula Kuan on August 2 for the first time as part of the trial runs between Mayapuri and South Campus on the upcoming Pink Line (Majlis Park - Shiv Vihar).
A Metro train passed through Delhi Metro's highest point at a height of 23.6 metres in Dhaula Kuan on August 2 for the first time as part of the trial runs between Mayapuri and South Campus on the up..
Read More
The height of the viaduct at Dhaula Kuan is 23.6mtrs and it is the highest point of Delhi Metro so far, surpassing Karkarduma where the Metro passes at a height of 19 metres above the ground.

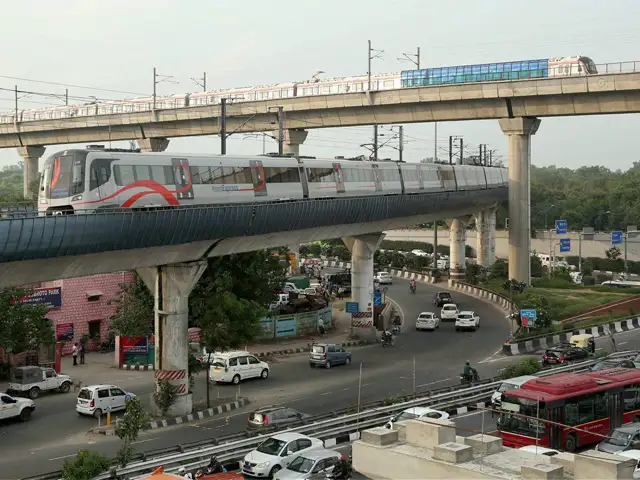

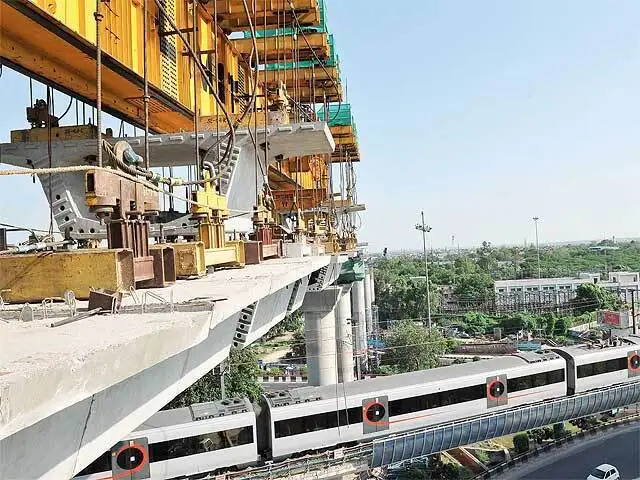

In Pic: A view of the Metro viaduct between the South Campus and Delhi Cantt Metro Stations of the under construction 59 km long Majlis Park- Shiv Vihar corridor of Delhi Metro’s Phase 3, at Dhaula Kuan in New Delhi.
The height of the viaduct at Dhaula Kuan is 23.6mtrs and it is the highest point of Delhi Metro so far, surpassing Karkarduma where the Metro passes at a height of 19 metres above the ground. In Pic..
Read More

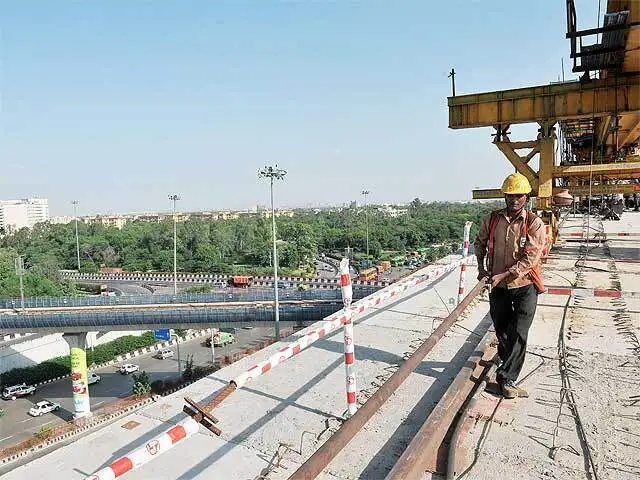

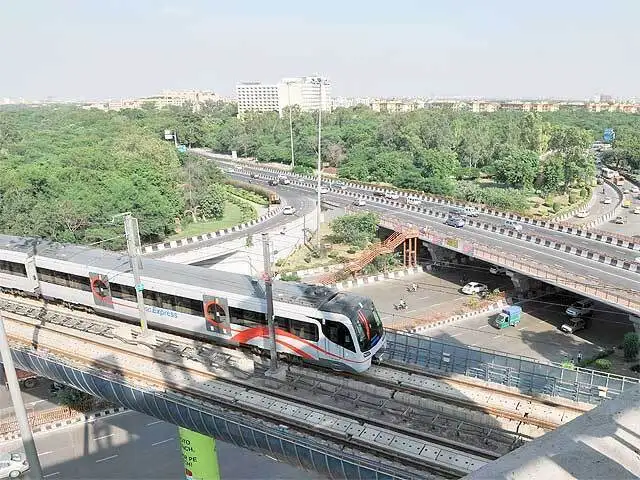

The Metro viaduct between South Campus and Delhi Cantonment metro stations of the under-construction 59 km-long Majlis Park-Shiv Vihar corridor, which will cross over the existing alignment of the Airport Express line at Dhaula Kuan, will be constructed without hampering movement of trains on the Airport Line and traffic movement between Ring Road and Sardar Patel Marg.

"The height of the viaduct will be 23.6 meters at this spot, as high as a 7 storey building, and will be the highest point of Delhi Metro so far surpassing Karkarduma where the Metro is 19 meters above the ground," DMRC Executive Director (Corporate Communications) Anuj Dayal said.
The Metro viaduct between South Campus and Delhi Cantonment metro stations of the under-construction 59 km-long Majlis Park-Shiv Vihar corridor, which will cross over the existing alignment of the Ai..
Read More

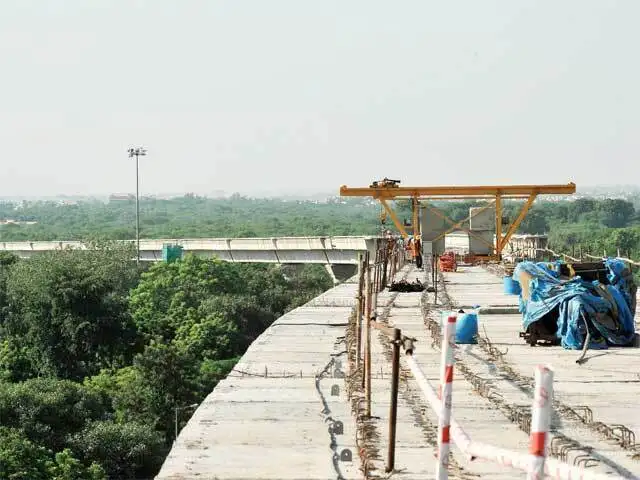

The "launching operation" above the Airport line is done only during non-operating hours between 12.30 AM till 4 AM to avoid any disruption to the traffic on Airport line.
The "launching operation" above the Airport line is done only during non-operating hours between 12.30 AM till 4 AM to avoid any disruption to the traffic on Airport line.
During this time, no activities for train operations are permitted on that portion of the Airport Express Line.

A diversion road has also been constructed so that there is no inconvenience to the commuters.
During this time, no activities for train operations are permitted on that portion of the Airport Express Line.

A diversion road has also been constructed so that there is no inconvenience to..
Read More
After getting clearances from Operation and Maintenances (O&M) Department of the Airport line, the launching work is done and all the parts of launcher are earthened before commencing work.

In Pic: A view of the Metro viaduct between the South Campus and Delhi Cantt Metro Stations of the under construction 59 km long Majlis Park- Shiv Vihar corridor of Delhi Metro’s Phase 3, at Dhaula Kuan in New Delhi.
After getting clearances from Operation and Maintenances (O&M) Department of the Airport line, the launching work is done and all the parts of launcher are earthened before commencing work.

Read More

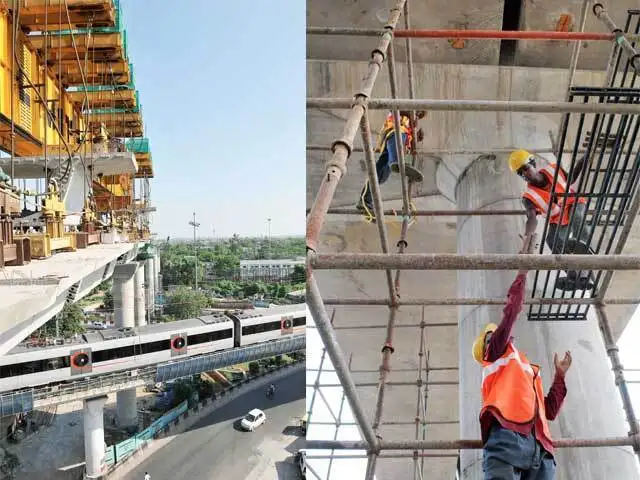

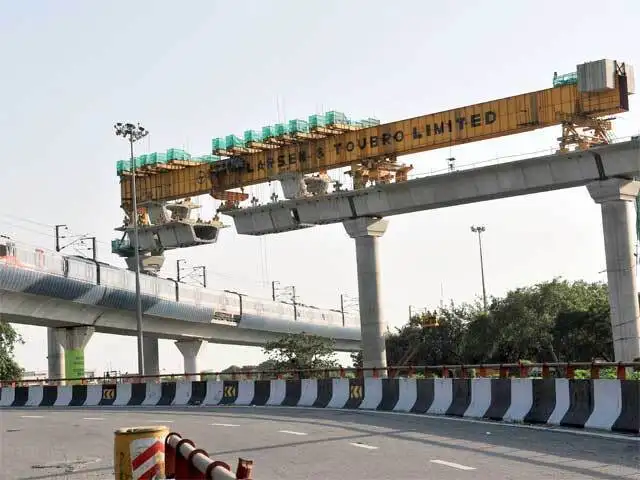

A team of six Civil Engineers, two safety experts, Engineers from O&M department and other experts are closely monitoring every movement of the launcher, weighing 350 tons, in the night so as to ensure that process of erecting segments over the existing viaduct and Over Head Electrification (OHE) of the Airport Express line is carried out smoothly without causing any damage to the already operational line, he added.
A team of six Civil Engineers, two safety experts, Engineers from O&M department and other experts are closely monitoring every movement of the launcher, weighing 350 tons, in the night so as to ensu..
Read More

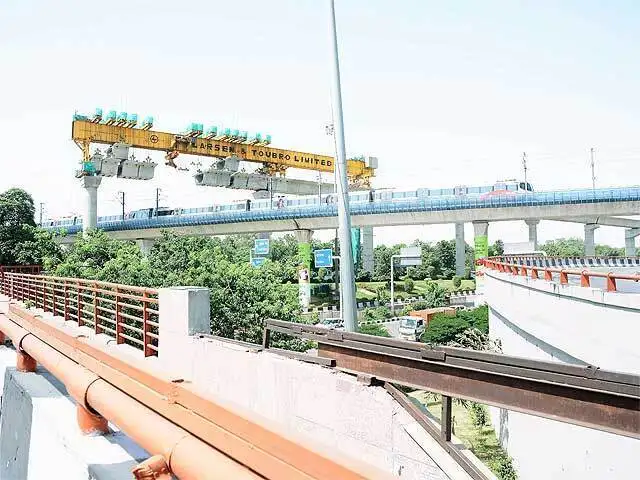

DMRC's design tram has also prepared the layout of the viaduct after closely studying the requirement of passing over major landmarks such as the Airport Line viaduct and the flyover at such a height.
DMRC's design tram has also prepared the layout of the viaduct after closely studying the requirement of passing over major landmarks such as the Airport Line viaduct and the flyover at such a height
The distance between the rail levels of this under construction line and existing Airport Express line is 11.90 meters.

The viaduct of the Airport Express Line is at a height of 11.7 meters from the ground level.
The distance between the rail levels of this under construction line and existing Airport Express line is 11.90 meters.

The viaduct of the Airport Express Line is at a height of 11.7 meters fr..
Read More

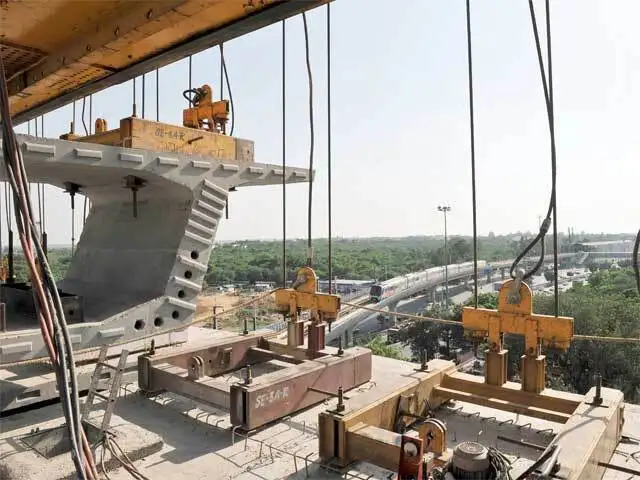

This under construction viaduct above the Airport express line, Sardar Patel Marg flyover and slip roads is 111 meters long and is supported by four piers of 23.6 meters height.
This under construction viaduct above the Airport express line, Sardar Patel Marg flyover and slip roads is 111 meters long and is supported by four piers of 23.6 meters height.
READ MORE
